Gunite Pool Build Timeline in New Orleans, Stage by Stage
Finished rectangular backyard pool with curved entry steps beside a brick pool house under tall pines

How Long Does It Take to Build a Gunite Pool in New Orleans?

Written by Big Easy Pool Builders

Key Takeaways

  • SwimmingPool.com puts a typical pool build at about 8 to 12 weeks from design to swim, and HomeGuide’s gunite guide, updated July 2025, puts the construction stretch alone at 6 to 8 weeks.
  • Design and permits both come before any digging, and SwimmingPool.com counts them inside its 8 to 12 week total.
  • The American Shotcrete Association recommends at least 7 days of curing for a new shell and a minimum 4,000 psi strength measured at 28 days.
  • On the Northshore and across the metro, summer storms and hurricane season (June 1 to November 30) are the local wild cards.
  • Making decisions early, from shape to finish, is the easiest way to keep your build moving.

How Long Does It Take to Build a Gunite Pool in New Orleans?

Quick Answer: A pool build takes about 8 to 12 weeks from design to swim, according to SwimmingPool.com, with HomeGuide putting the gunite construction stretch alone at 6 to 8 weeks. Around Slidell and Madisonville, heavy summer rain and hurricane season can stretch any stage, so plan with some room in the calendar.

Gunite takes longer than some pool types because the concrete is sprayed and cured on site. That’s also why it can take any shape you want. If you’re new to the material, our guide to what a gunite pool is explains the basics. Below is how the schedule usually breaks down, stage by stage.

What Happens Before Anyone Digs?

SwimmingPool.com estimates 1 to 4 weeks for the design phase. This is where you settle the shape, depth, steps, and any spa or water feature. Our post on choosing the right pool size and shape is a good place to start thinking before the first meeting.

Permits also come before any digging, and your parish sets that pace. Our advice for Slidell and Madisonville owners: lock the design early, since changes after the permit is submitted are an easy way to lose time.

How Long Do Excavation and Steel Take?

According to SwimmingPool.com, digging usually takes only 1 or 2 days, though it budgets about a week for excavation to allow for complications like limited access or utility lines. Next comes the steel, plumbing, and electrical rough-in, which it estimates at 1 to 2 weeks depending on the size and complexity of the pool.

This is where our soft alluvial soil and wet weather come into play. A dig that fills with rainwater or a yard too soft for equipment has to wait. Our advice for Slidell yards: watch the forecast around this stretch, because an open hole and a summer downpour don’t mix.

What Happens on Shoot Day, and How Long Does Gunite Cure?

Shoot day is when the crew sprays gunite over the steel and shapes the floor and walls, steps included. The concrete work itself moves fast. The waiting comes after.

The American Shotcrete Association (ASA) recommends a minimum of 7 days of curing to help control shrinkage in young concrete. It also warns that a lack of curing, plus hot or dry exposure, raises the risk of shrinkage cracking. ASA recommends a minimum of 4,000 psi for pool gunite, measured at 28 days.

That doesn’t mean every step waits a full 28 days. Your builder decides when the shell is ready for tile and the finish coat. What you shouldn’t see is a shell left to bake dry in August heat. Keeping it wet in the first week is part of the job, and it’s worth asking who handles it on your project. You can read more about how we approach the shell on our gunite pool construction page.

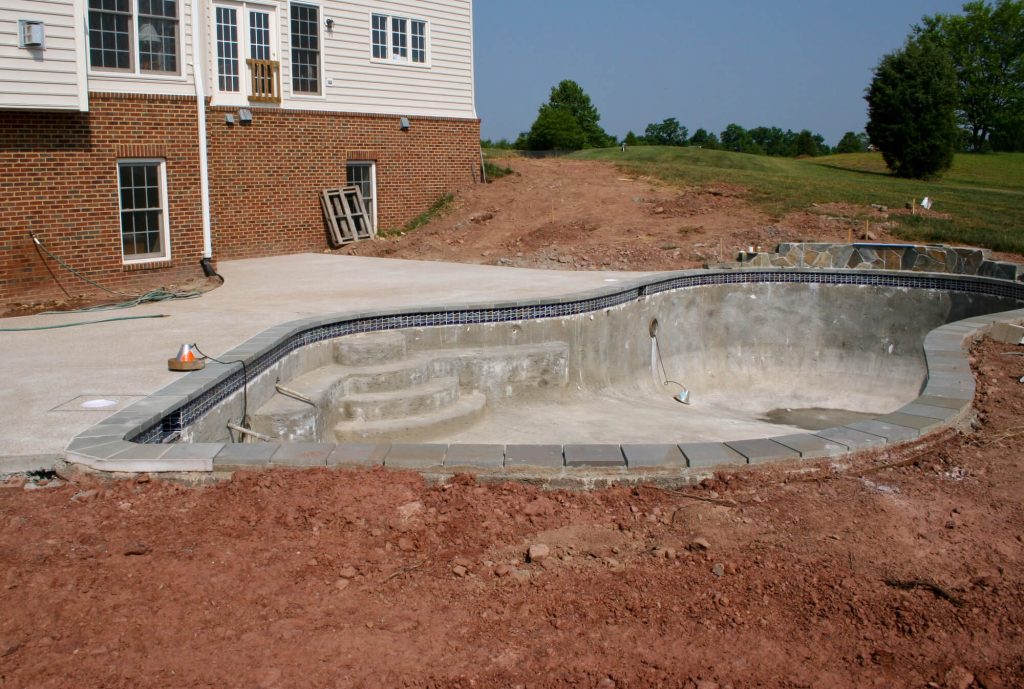

Unfinished kidney-shaped concrete pool shell with bare walls and built-in steps, a blue waterline tile band, and gray coping, surrounded by bare dirt beside a brick house

How Long Do Tile, Coping, Plaster, and Start-Up Take?

SwimmingPool.com estimates 1 to 3 weeks for the gunite and plastering stage and 1 to 4 weeks for deck and landscaping work. On a typical job, the finishing stretch covers the pieces below, though the exact order varies by builder and site:

  • Tile and coping. Waterline tile and the edge around the pool go on once the shell is ready.
  • Equipment. The pump and filter are set and connected, along with any heater. If you’re planning to heat the water, our look at what a pool heater costs in Louisiana can help you budget.
  • Deck. The surrounding hardscape is poured or laid.
  • Interior finish. Plaster or a pebble finish goes on, then the pool is filled and the water is balanced before anyone swims.

The finish you pick now is the one you’ll renew years down the road, so it’s worth knowing the long-term side too. Our guide to pool replastering costs in New Orleans covers what that looks like.

How Does Louisiana Weather Change Your Schedule?

Summer rain

Afternoon storms are a normal part of a Louisiana summer, and they hit the early stages hardest. Excavation and deck work both need ground dry enough to work on. A few wet days in a row can push the next crew back.

Hurricane season

The National Hurricane Center lists the Atlantic hurricane season as June 1 to November 30, with most activity between mid-August and mid-October. A named storm in the Gulf doesn’t have to hit Slidell or Madisonville to pause a job site. Our advice: ask your builder how materials and equipment get secured when a storm threatens.

Heat

Heat speeds up drying, which is exactly what a fresh gunite shell doesn’t want. That’s one reason curing gets extra attention in July and August.

When Should You Start If You Want to Swim by Summer?

SwimmingPool.com’s 8 to 12 weeks works out to roughly 2 to 3 months from first meeting to first swim, before any weather delays. HomeGuide suggests building during the off-season or colder months as a way to save money, and our mild winters make that realistic here. Starting in fall or winter also puts most of the construction outside the peak of storm season.

Our swim season is long, so there’s no bad month to have a pool. But if Memorial Day is the goal, begin design talks well before spring.

How Can You Keep Your Build on Schedule?

  • Lock in the shape and the finish before permits are submitted.
  • Clear a path for equipment to reach the backyard.
  • Pick your tile and plaster colors early so materials are on hand.
  • Ask for a written schedule and a plan for rain days.

Whether you’re planning a custom pool with an attached spa or a simpler rectangle, fewer mid-build changes means fewer delays.

Frequently Asked Questions

How long does it take to build a pool of any type?

SwimmingPool.com gives 8 to 12 weeks on average, design and permits included. It notes that a gunite pool takes a little longer, since the crew needs time to plaster and the gunite can take up to a week to cure.

How long does gunite need to cure before plaster?

ASA recommends at least 7 days of curing, and its strength target is measured at 28 days. Your builder sets the exact timing for the finish coat.

Does a bigger pool take longer to build?

Usually. HomeGuide notes that build time depends on the pool’s size and how much site prep your property needs. Features like a spa or waterfall add steps too.

Will hurricane season stop my pool build?

Not for the whole season. Work can continue on clear weeks, with a pause to secure the site when a storm threatens. Plan for a few lost days if one comes close.

Plan Your Gunite Pool in Slidell or Madisonville

We’ll walk your yard, map out the stages, and give you a realistic schedule for your lot. We build across the Northshore, including Slidell and Madisonville, plus New Orleans and Baton Rouge.

Request a free consultation or call (504) 608-4680.
